Here’s a summary outlining the next steps for the CRMA to enter into legal force.

All being well that would be March/April 24, so should coincide nicely with the expansion plan, whatever it looks like. Surely classified as a Strategic Project under the Act at that time, I have no doubt MT is going to go f*%king huge after this 3 year permit process.


  • Like
  • Love
Reactions: 5 users
Here’s a summary outlining the next steps for the CRMA to enter into legal force.

All being well that would be March/April 24, so should coincide nicely with the expansion plan, whatever it looks like. Surely classified as a Strategic Project under the Act at that time, I have no doubt MT is going to go f*%king huge after this 3 year permit process.


"I have no doubt MT is going to go f*%king huge after this 3 year permit process"

Related question - I'm Interested to know what the maximum size of any Niska+ study can be based on the current MRE, ie without further drilling and discovery. I've attempted a stab at this below.

Can someone remind me of the asx/jorc rules on what can quantities of resource can be included in the studies based on various confidence levels? I've extrapolated based on what Talga have published previously.

eg The Vittangi DFS uses only probable ore reserves from Nunasvaara South

The Niska Study (2020) was based on Nunasvaara North and Niska N & S and used approx 80% of the indicated resource and effectively none of the inferred, to get to 400,000tpa ore for 12 years = 5.1Mt ore. (see below)

Screen Shot 2023-10-10 at 10.30.12 am.png




Based on current updated MRE excluding Nunasvaara South (for Vittangi) and adding in the newer Nunasvaara East and Niska Link, the indicated category gives approx 14.6Mt mineable ore (see below)

Screen Shot 2023-10-10 at 10.40.26 am.png



For Niska study 400,000tpa ore yielded ~85,000tpa Tal-C. Since then the average grade in the MRE above has reduced from 28.7%Cg to 24%. This is similar to Vittangi where at 24%Cg, 100,000tpa ore yields 19,500tpa Tal-C so a good reference to use.
Keeping the Niska 14 year LOM, that's 1.05Mtpa ore and 205,000tpa Tal-C.


So I believe that based on these back-of-the-envelope calcs, currently any Niska+ study published would bound by an upper limit of approx 200,000tpa Tal-C based on current MRE and reporting rules.

The numbers for that would be great - approx NPV8 of US$8.5bn / A$13bn as a simple multiple of the Niska study base case (and nearly A$17bn at the upper range)


Caveat with lots of assumptions with the original Niska base case of US$3.5bn won't hold up in the 3 years that have passed since publication. Discount rate of 8% is just not appropriate in this market (eg when Minres are borrowing at >9%), capex and opex increases across the board, AAM price depressed etc etc.
Also shows there is a lot of drilling to do for resource expansion to get to the theoretical 800ktpa anode in the Euroz Hartleys bull case! Good job MT loves to drill.

I am not a geo and have likely made mistakes here so keen for some input.

  • Like
  • Love
Reactions: 9 users

Monkeymandan

Regular
"I have no doubt MT is going to go f*%king huge after this 3 year permit process"

Related question - I'm Interested to know what the maximum size of any Niska+ study can be based on the current MRE, ie without further drilling and discovery. I've attempted a stab at this below.

Can someone remind me of the asx/jorc rules on what can quantities of resource can be included in the studies based on various confidence levels? I've extrapolated based on what Talga have published previously.

eg The Vittangi DFS uses only probable ore reserves from Nunasvaara South

The Niska Study (2020) was based on Nunasvaara North and Niska N & S and used approx 80% of the indicated resource and effectively none of the inferred, to get to 400,000tpa ore for 12 years = 5.1Mt ore. (see below)

View attachment 46699



Based on current updated MRE excluding Nunasvaara South (for Vittangi) and adding in the newer Nunasvaara East and Niska Link, the indicated category gives approx 14.6Mt mineable ore (see below)

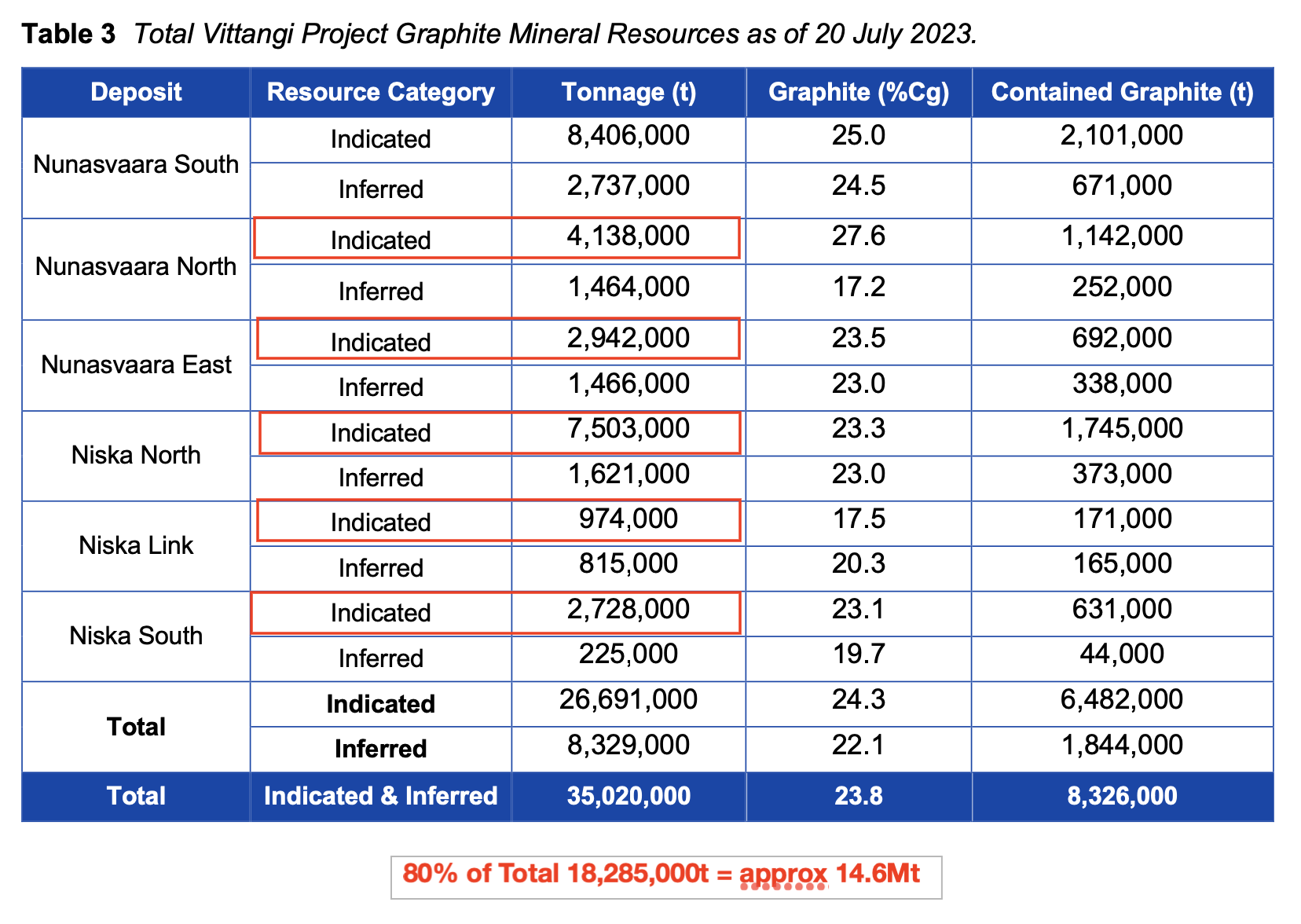

View attachment 46700


For Niska study 400,000tpa ore yielded ~85,000tpa Tal-C. Since then the average grade in the MRE above has reduced from 28.7%Cg to 24%. This is similar to Vittangi where at 24%Cg, 100,000tpa ore yields 19,500tpa Tal-C so a good reference to use.
Keeping the Niska 14 year LOM, that's 1.05Mtpa ore and 205,000tpa Tal-C.


So I believe that based on these back-of-the-envelope calcs, currently any Niska+ study published would bound by an upper limit of approx 200,000tpa Tal-C based on current MRE and reporting rules.

The numbers for that would be great - approx NPV8 of US$8.5bn / A$13bn as a simple multiple of the Niska study base case (and nearly A$17bn at the upper range)


Caveat with lots of assumptions with the original Niska base case of US$3.5bn won't hold up in the 3 years that have passed since publication. Discount rate of 8% is just not appropriate in this market (eg when Minres are borrowing at >9%), capex and opex increases across the board, AAM price depressed etc etc.
Also shows there is a lot of drilling to do for resource expansion to get to the theoretical 800ktpa anode in the Euroz Hartleys bull case! Good job MT loves to drill.

I am not a geo and have likely made mistakes here so keen for some input.
Hi Curiousmagie

Your calcs look logical and relying only on the Indicated category is right I think, however I would have thought the indicated category for Nunn South should be included too - less the ore that is already earmarked for phase 1 Vittangi (104ktpa ore x24y LOM = 2.5mt ore. 8.4m - 2.5m = 5.9mt ore balance). I say this because I see the Niska+ scope as likely to mop up every bit of excess indicated resource.

So that would bring your 18.3mt ore to 24.2mt ore. 80% being 19.4mt, giving approx 4.1mt TalC, or 293ktpa TalC over 14 year life of mine.

I did my own rough calcs some time ago and landed on a figure of 300ktpa, so this seems pretty consistent.

So I’ll take your NPV $13bn AUD and raise you $19.5bn!

All just my opinion.

  • Like
  • Love
Reactions: 10 users

Semmel

Top 20
I did a little bit investigation in this. And (i edited that part out of the first version of the post as it was repeating yours.. sorry!) .. where does the notion of using 80% of the inferred resource comes from? I mean, yes, the numbers line up, but why would they do that?

However, the resource STILL remains open at strike and at depths. So there is almost certainly even more to be mined in the area.

I understand the conservative approach using JORC standard. There are probably plenty of projects that got their nose bitten off because they thought they had more ressources than truely were there. It makes sense to low-ball the resource size and be conservative. Better to increase the mines scope when it actually turns out to be more mineral available.


HOWEVER, that approach is NOT GOOD in SWEDEN. The limiting factor for a mine is NOT its size or the mineral. Its the legal process to open the mine in the first place. The scale of the project is almost insignificant. In Australia, its probably no big deal to increase the scope of a mine if more minerals are found. In Sweden, it takes a decade to get this through. At the same time, the initial permit does not seem to depend on the scale of the project but solely dominated by the speed the court can handle opposition. And opposition is at break-neck intensity for even digging out a hole for a fence post. It doesnt matter how large the project is, opposition is maximum, all the time.

So as a result, I think the best strategy for Talga to proceed here is go for a permit application of a mine that takes 5Mtpa ore out, for a 1Mtpa Cg extraction rate. This application would take the exact same time and efford as a project for half or 1/3 that scale. Then, when they actually build the mine, they can scale back the size. Or go for the full scale if the resource strike and depth still remains open, even after getting the inferred resource to 100Mt ore.

There is also another aspect. A mine with much longer life span of 20 years is not fiesible for graphite. Within 20 years, and probably much sooner, the enegry environment will change completely. We will have almost 100% renewable energy in form of solar and wind, which will be abundand and much cheaper than coal and gas. We will go into a future similar to Tony Sebas Super power, I am certain of that. I posted about the solar installation aspect in the other thread a week or so ago. With almost free energy, synthetic graphite will become super cheap. So cheap that our mine will not be profitable in comparison. Now, we are not there by a long shot yet, but... as slow as the legal process is in Sweden, it will take at least 5 years before we have the permits for an expansion. Then another 2 to 3 years of building the mine and refinary. So we will start at EARLIEST in 8 years with the mine. On top of that, go a 20 year life of mine, and .. at the tail end, it might ot be all that profitable any more.

What I want to say with that is.. be fast, and dont plan for a long lasting graphite mine.

  • Like
  • Thinking
